BDC resubmission · September 2026

Development & construction budgets

LLAYDLLAYD

Hard, soft and financing costs by parcel. The GC fee, escalation and contingency are shown separately.

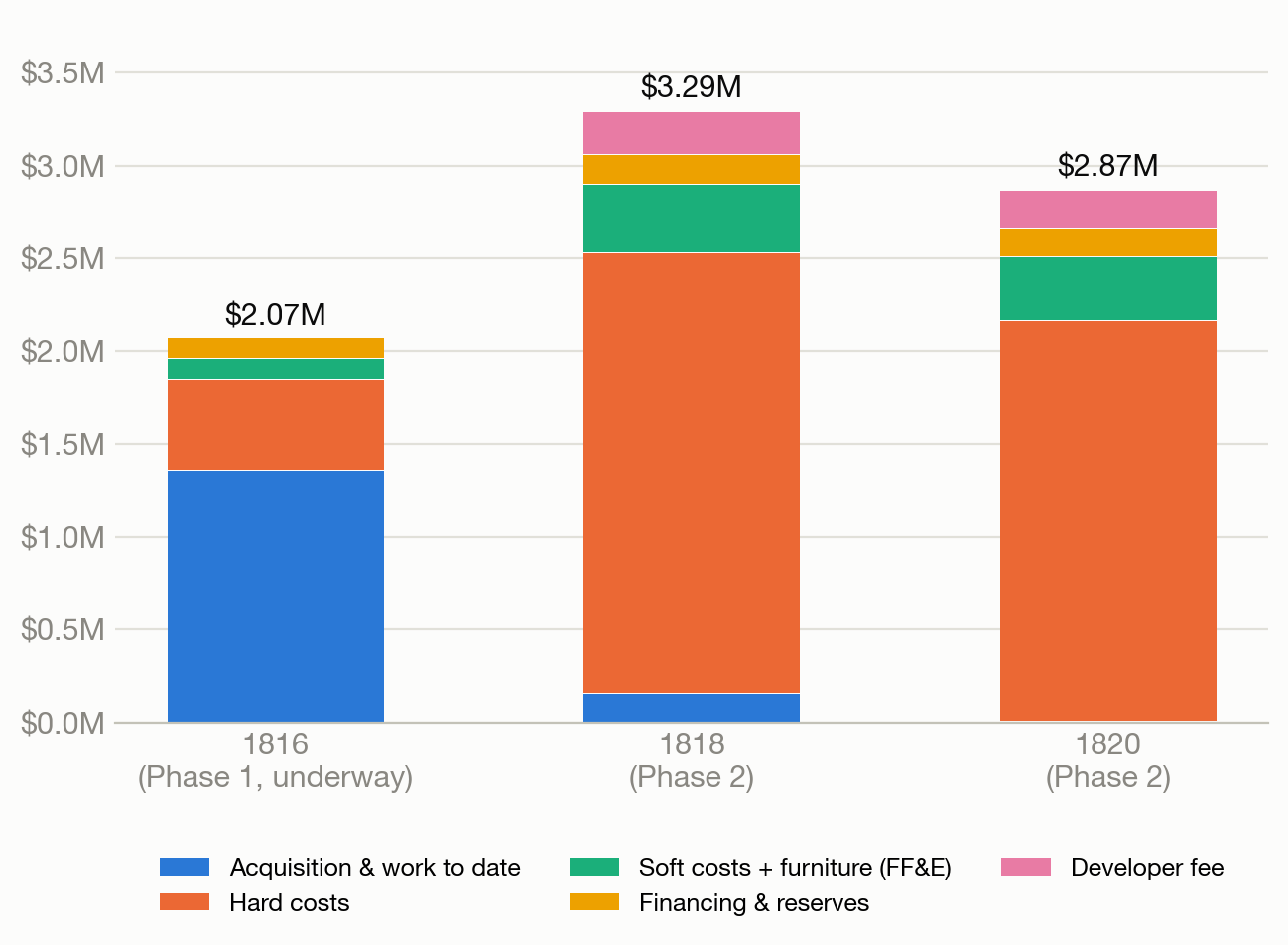

Development cost by parcel
Development cost by parcel
  • 1818/1820 hard costs run ≈$343/GSF all-in. Benchmarks: DHCD rehab cost limits $202–$277/SF before contingency, and 1816's actual bids.
  • Escalation 6%; contingency 12.5% (10% on 1816's already-bid scope).
  • GC fee 8% (related party, disclosed, below the DHCD 17% cap).
  • Soft costs: A&E 7%, permits 1.5%, legal 1%, builder's risk 1.2%, plus reports, marketing and a 5% contingency.
  • Developer fee 8% on Phase 2 only, 50% deferred.

Uses of funds by parcel

Use181618181820Total
Acquisition$300,000$150,000$3,000$453,000
Closing & transfer$36,052$7,500$7,500$51,052
Work completed to date$797,000$0$0$797,000
Carrying costs to date$230,744$0$0$230,744
Hard costs (GC fee, escalation, contingency)$483,648$2,374,617$2,159,731$5,017,996
Soft costs$31,000$284,901$260,758$576,659
Furniture, fixtures & equipment$82,500$82,500$82,500$247,500
Financing costs$35,151$80,243$72,982$188,376
Operating reserve$75,686$81,485$74,007$231,178
Developer fee (50% deferred)$0$232,300$211,998$444,298
Total uses$2,071,780$3,293,546$2,872,477$8,237,803

Construction budget

Line item181618181820Total
1816 — remaining scope
Commercial fit-out & façade (BRNI advance scope)$125,000$125,000
Residential completion: 4F interior framing, drywall, finishes, MEP trim$152,000$152,000
Fire sprinkler (Fuentes, NFPA 13R) + fire alarm & backflow$45,000$45,000
Gut rehab by trade division (1818 existing / 1820)
General conditions, site protection & dumpsters$35,150$67,725$102,875
Selective demolition & debris removal$35,150$67,725$102,875
Structural repairs, framing & fire blocking$84,360$162,540$246,900
Masonry (interior), stairs & fire-rated assemblies$35,150$67,725$102,875
Roofing & sheet metal$28,120$54,180$82,300
Windows & exterior doors (CHAP-compliant wood)$49,210$94,815$144,025
Plumbing (stacks, risers, fixtures, water heaters)$77,330$148,995$226,325
HVAC (ductless / split systems, ventilation)$70,300$135,450$205,750
Electrical service, distribution, lighting$70,300$135,450$205,750
Insulation & drywall (1-hr rated)$63,270$121,905$185,175
Flooring, paint, trim & millwork$63,270$121,905$185,175
Kitchens & baths (cabinets, counters, tile, appliances)$77,330$148,995$226,325
Interior doors, hardware, specialties & closets$14,060$27,090$41,150
Premium flooring — Brazilian cherry or imported porcelain (upgrade)$30,140$41,250$42,900$114,290
Smart-home & premium appliance package$27,000$27,000$27,000$81,000
Private rear decks 18′ × 8′$41,040$41,040$41,040$123,120
Electric outdoor cooking stations$19,500$19,500$19,500$58,500
1818 vertical addition (3rd & 4th floors)$845,000$0$845,000
Historic façade restoration$65,000$90,000$155,000
Commercial white-box & storefront$45,000$45,000$90,000
Fire sprinkler + alarm + backflow$32,000$32,000$64,000
Environmental abatement allowance$25,000$25,000$50,000
Direct construction subtotal$439,680$1,843,790$1,676,940$3,960,410
Cost escalation to midpoint$0$110,627$100,616$211,244
GC overhead & profit (Tyjuan Amor LLC, disclosed)$0$156,353$142,205$298,558
Hard cost contingency$43,968$263,846$239,970$547,784
TOTAL HARD COSTS$483,648$2,374,617$2,159,731$5,017,996

Furniture (FF&E, outside hard costs): 1816 $82,500 · 1818 $82,500 · 1820 $82,500.

Soft costs: 1816 $31,000 · 1818 $284,901 · 1820 $260,758. The live version is on the Construction_Budget tab of the Excel model.

Prepared by Live Life As You Dream (LLAYD) LLC & Tyjuan Amor LLC for Baltimore Development Corporation and NIIF · September 17, 2026
